Paekākāriki seawall
February 2026
Stage one of the replacement like-for-like timber seawall in Paekākāriki is expected to begin on Monday 16 March. The first section will replace a 100-metre section of the 900-metre-long seawall on The Parade between Paneta Street and Tangahoe Street.
The start date is dependent on weather and wildlife clearance in line with our permit. While our coastal environment and the weather can be unpredictable, we’re hoping this first stage will take about six to nine months to complete.

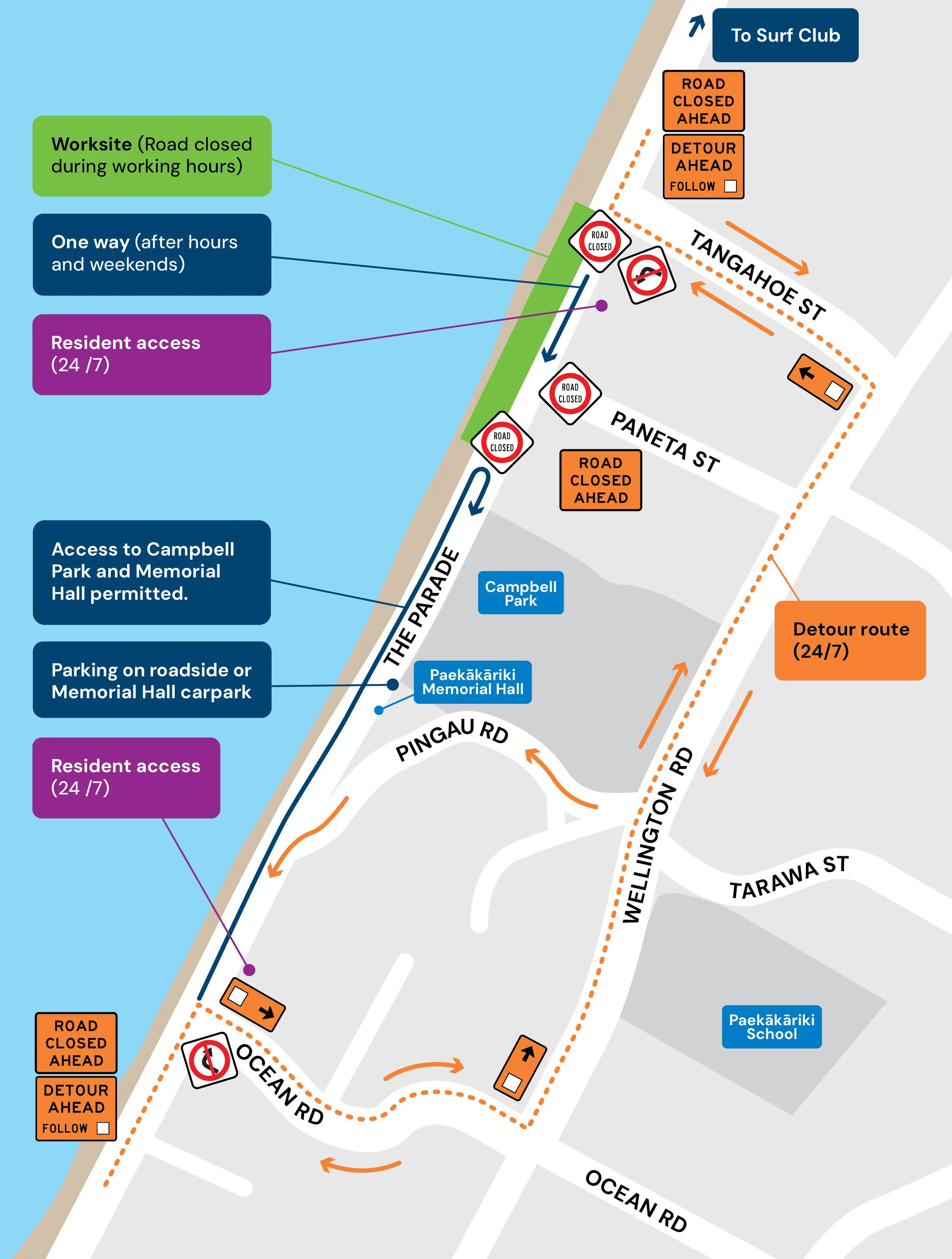

Traffic management plans will be in place to ensure the public’s safety. These may include full road closures and detours, temporary one lane closures, and stop/go. It will depend on the work happening on the day. Our aim is to be as least disruptive as possible and ensuring residents have access to their properties.

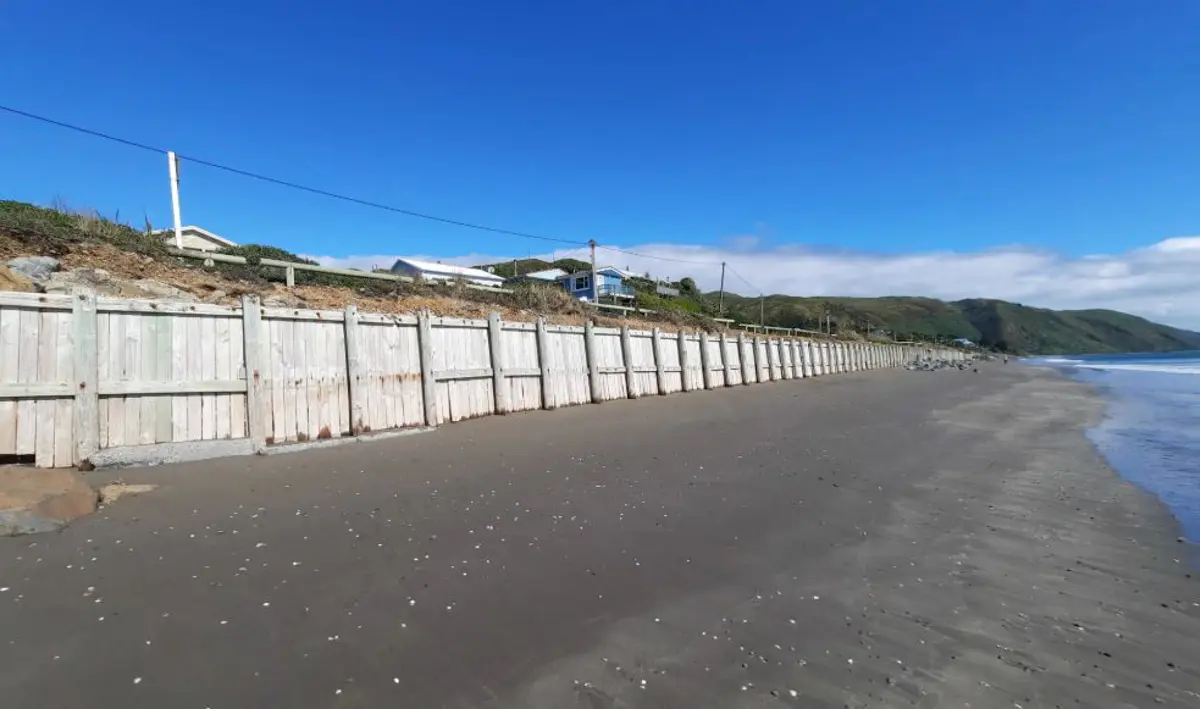

Current timber seawall at Paekākāriki
Background
The current seawall has deteriorated and needs to be replaced to continue to protect the road and other public infrastructure.
In the Long-term Plan 2021–41, Council consulted on options for renewing or replacing the seawall. More than 70 percent of submitters agreed with the preferred option to replace the wall in timber, incorporate improved beach access and work with the community on artistic elements.
Following the decision to replace the Paekākāriki seawall with a like-for-like timber wall, we budgeted $17.85 million in our Long-term Plan 2024-34 for this significant infrastructure investment. The wall’s design life will be 20 years.
Staged approach

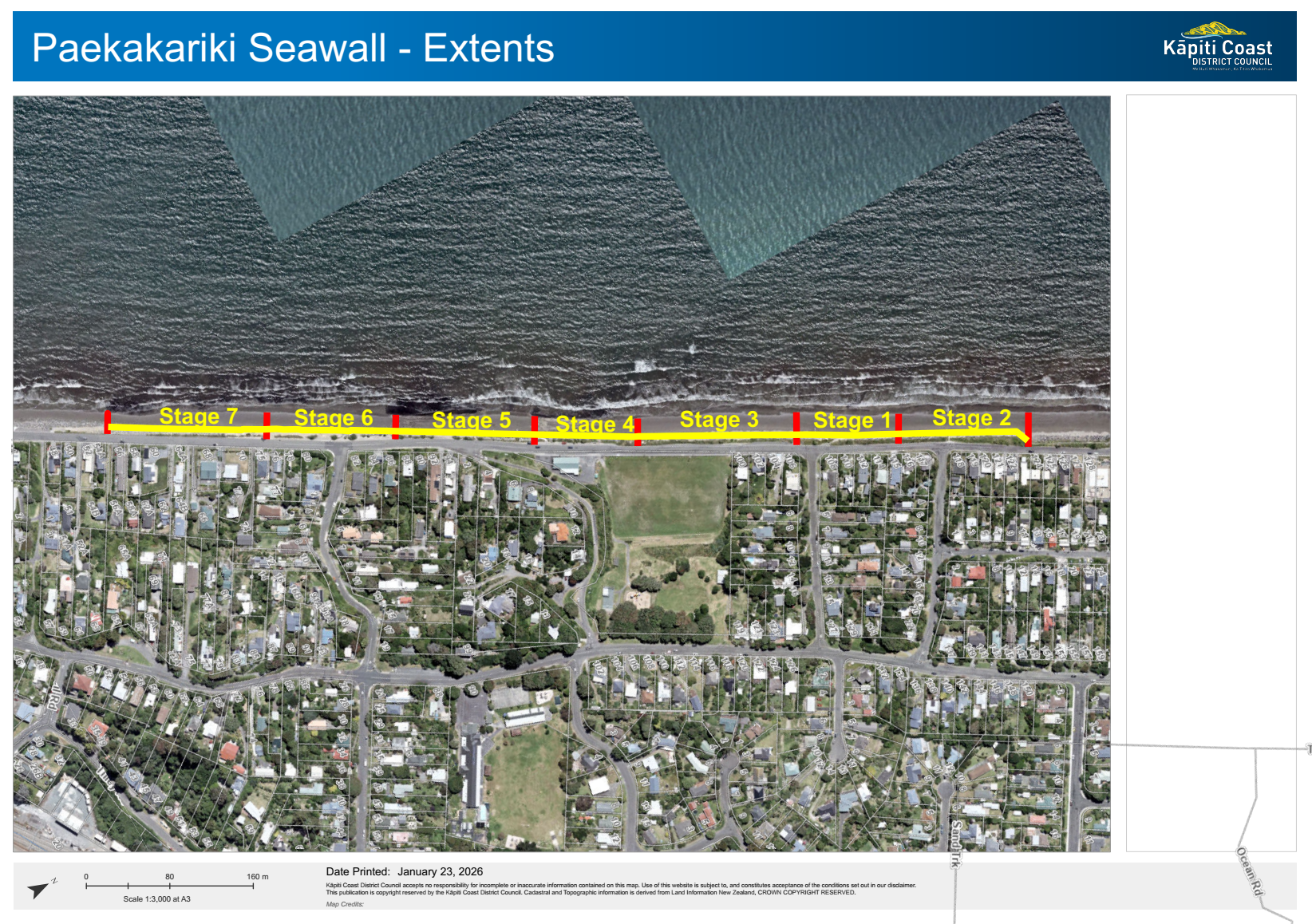

The timber wall will be replaced in stages over the next six years. This staged approach will help minimise community disruption, smooth the financial impact, and help local contractors plan works for when the weather is more reliable.
The first stage is based on condition assessments done in 2024 and will be completed where the most immediate need is first. Subsequent stages may change as condition assessments will be done on a yearly basis to confirm the work programme.

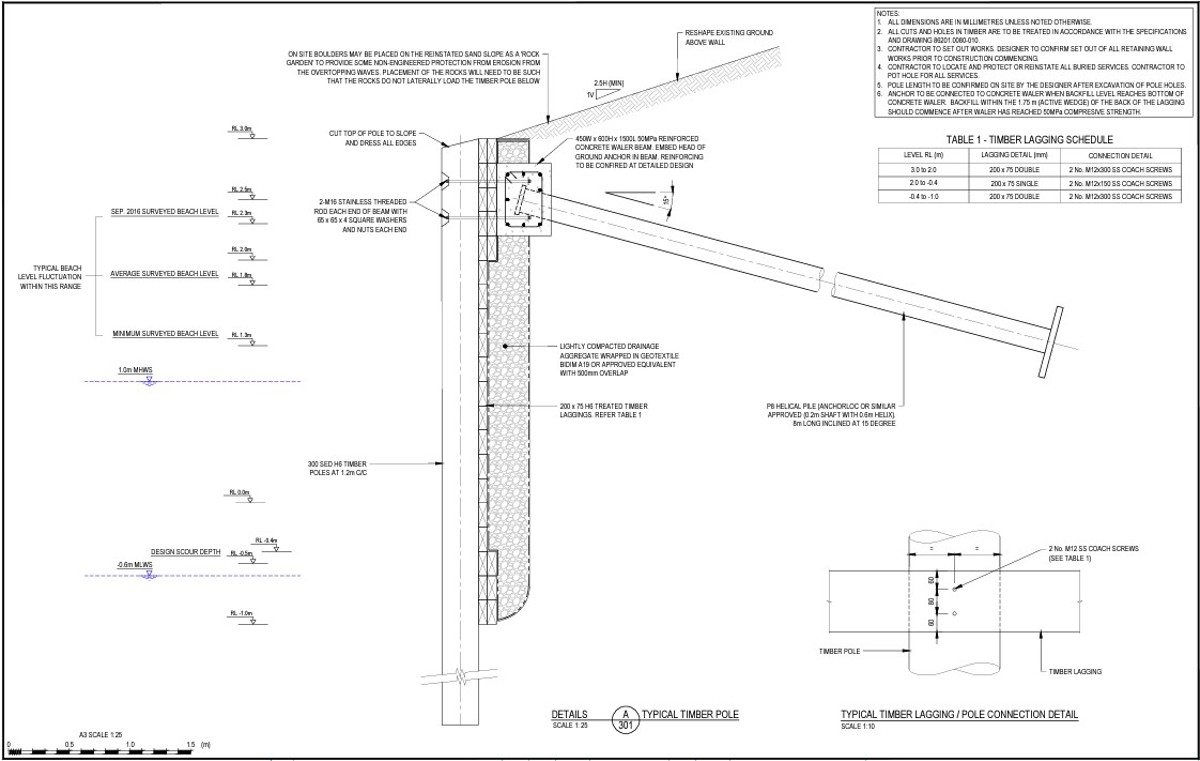

A 3-metre section behind the new wall will include stabilising material to stop scouring and preventing future failures.
Our maintenance programme for the rest of the seawall will continue alongside the replacement project.

Accessways

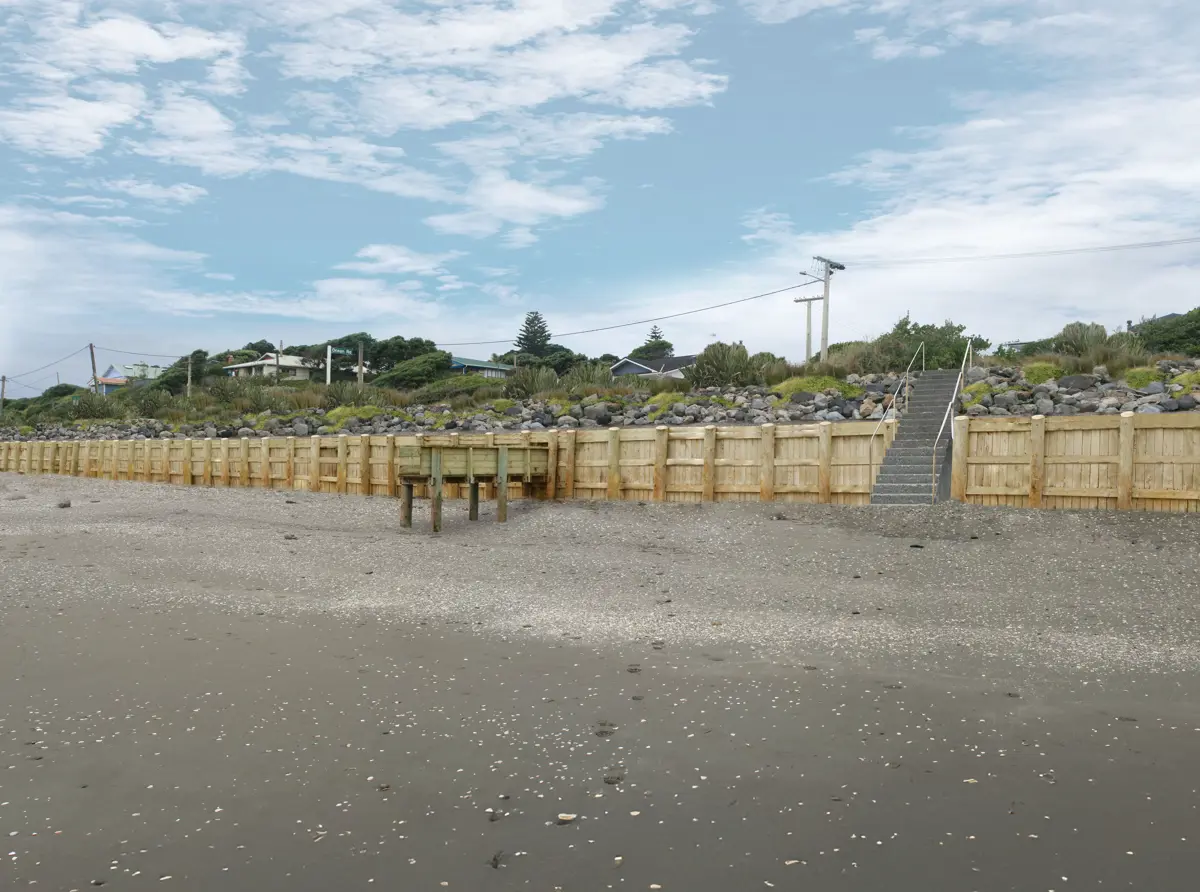

Accessible access to the beach will be installed opposite Tangahoe Street, Ocean Road, and Campbell Park. This means there will be beach access approximately every 250 metres.

Destination accessway
Original designs included a destination accessway opposite Campbell Park however, due to consenting and budget restraints, we have since identified a potential location opposite Henare Street. This site will allow for an improved amenity, landscaping, and parking and accessibility.
Wildlife considerations
We have a penguin management plan in place to ensure no penguins are present before each stage begins.
We’re also working with an ecologist specialist to relocate any native lizards to lizard hotels in the Paekākāriki Escarpment before work begins on each stage. This includes predator control and live capture and release as permitted under the Wildlife Act.
Design
Council is working with Ringa Toi Ropu (Paekākāriki Seawall Art Working Group – PSWAG) to incorporate artwork by local artists and a cultural thread in the design. As far as possible this will incorporate the objectives of the original Paekākāriki Seawall Design Group and the Paekākāriki Community Board. Projects include woven taniko, landscape planting, and a structural base for a Ngāti Haumia feature sculpture.
Affordability will continue to be a key consideration because Council must balance the community's aspirations with the need to apply a fair and consistent approach to coastal management across the district while continuing to operate within its financial means.
- Paekākāriki Seawall Community Presentation (12 Feb 2017) [PDF 828 KB]
- Paekākāriki Seawall Preliminary Design Drawings [PDF 5.04 MB]
- Paekākāriki Seawall Resource Consent Application (March 2016) [PDF 16.87 MB]
- Paekākāriki Seawall Resource Consent Certificate [PDF 234 KB]
- Paekākāriki Seawall Resource Consent Officer's report (2 May 2016) [PDF 463 KB]
- Shovel-ready projects identified to help Kāpiti recovery (7 May 2020)
- Plan for building a stronger Kāpiti adopted (28 June 2018)
- Paekākāriki seawall construction delayed (21 Aug 2017)
- Design of new Paekākāriki Seawall progressing (17 Feb 2017)
- Council plans for the year ahead take shape (10 June 2016)
- Consent for Paekākāriki seawall (5 May 2016)
- Kāpiti residents could face a lower than projected rates rise (18 March 2016)
