Ōtaki Reservoir
We received a $29.3 million contribution from Kāinga Ora’s Infrastructure Acceleration Fund to help fund water and transport infrastructure to improve resilience and support new homes in Ōtaki. You can read more about this on our A blueprint for Ōtaki page.
The first project to be built is a new reservoir for Ōtaki. The reservoir will improve the resilience and fire-fighting capability of the Ōtaki water supply.

Artist impression of the Ōtaki Reservoir with trees near fully grown.
Ōtaki has limited water storage and relies on bores and pumps to supply the community. This system does not meet good practice standards. If a problem occurred with the pumps or the treatment station, then most of Ōtaki would lose their water supply. The new reservoir will provide 24 hours of water storage.
Council will be building a new 5.5-million-litre reservoir on Te Manuao Road. We chose this site because of its height above sea level, and closeness to the water reticulation network.
We’ll work with the community to develop a plan to screen the reservoir from homes.
The new reservoir will:
- improve the resilience of the Ōtaki water supply
- improve firefighting capability for Ōtaki
- provide water storage for emergencies and times of high demand
- support the significant housing growth planned for Ōtaki
- be more energy efficient.
We’ll be designing and building the reservoir to Aotearoa New Zealand earthquake standards. It will be strong enough to stand up to a one-in-2,500-year earthquake. The project includes laying approximately 4 kilometres of pipes to carry water to the reticulation network.
We expect to start earthworks in October 2023, and construction of the tank in early 2024.

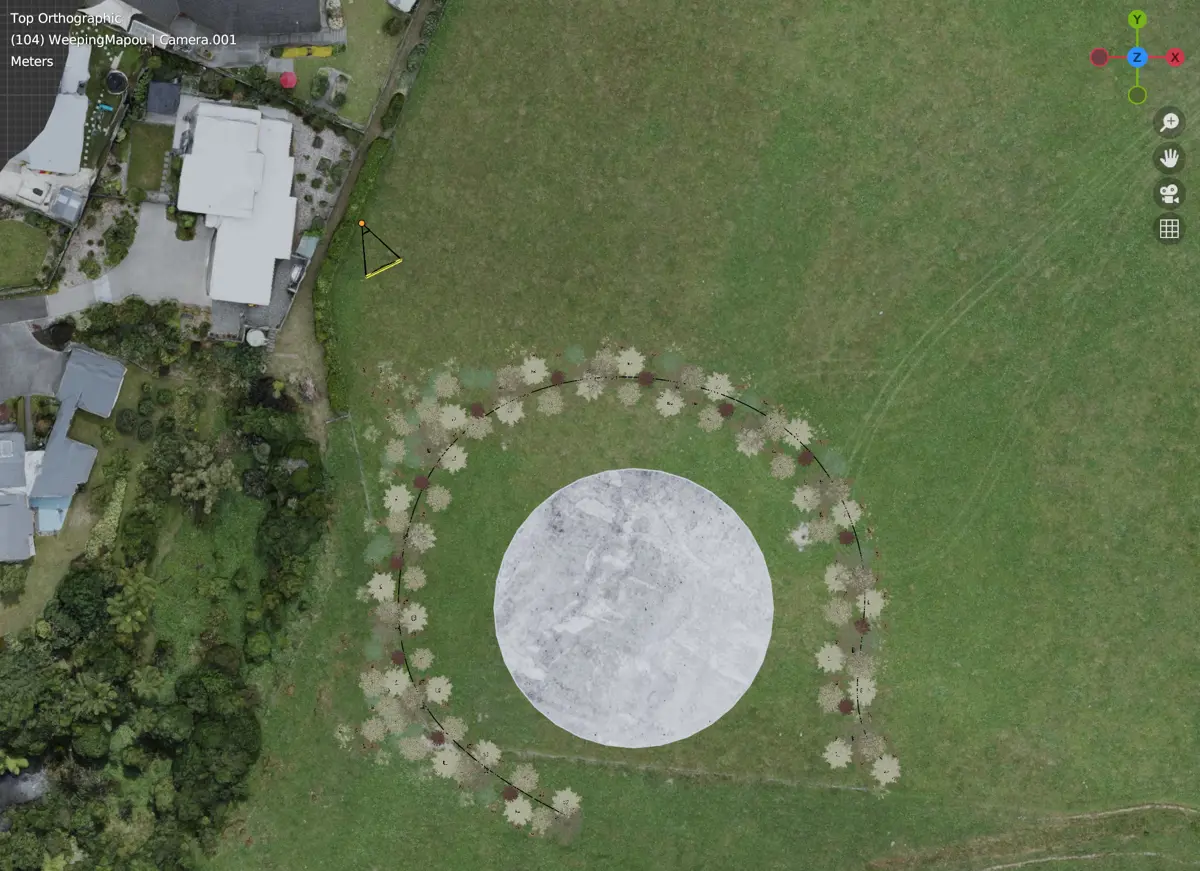

Ōtaki Reservoir planting plan.
Key features
The reservoir by the numbers:
5.5 million litres (5,500m3) |
volume of the reservoir |
35 metres |
diameter of the reservoir |
6 metres |
depth of water in the reservoir |
7 metres |
height of the reservoir |
53 metres |
maximum height of the reservoir above sea level |
267 |
the number of native trees that will be planted around the reservoir |
100 years |
reservoir design life (length of time the reservoir can be used with maintenance but without major repair being needed) |
2,500 years |
reservoir designed to withstand an earthquake of this frequency (making it the strongest structure in the area) |
4 kilometres |

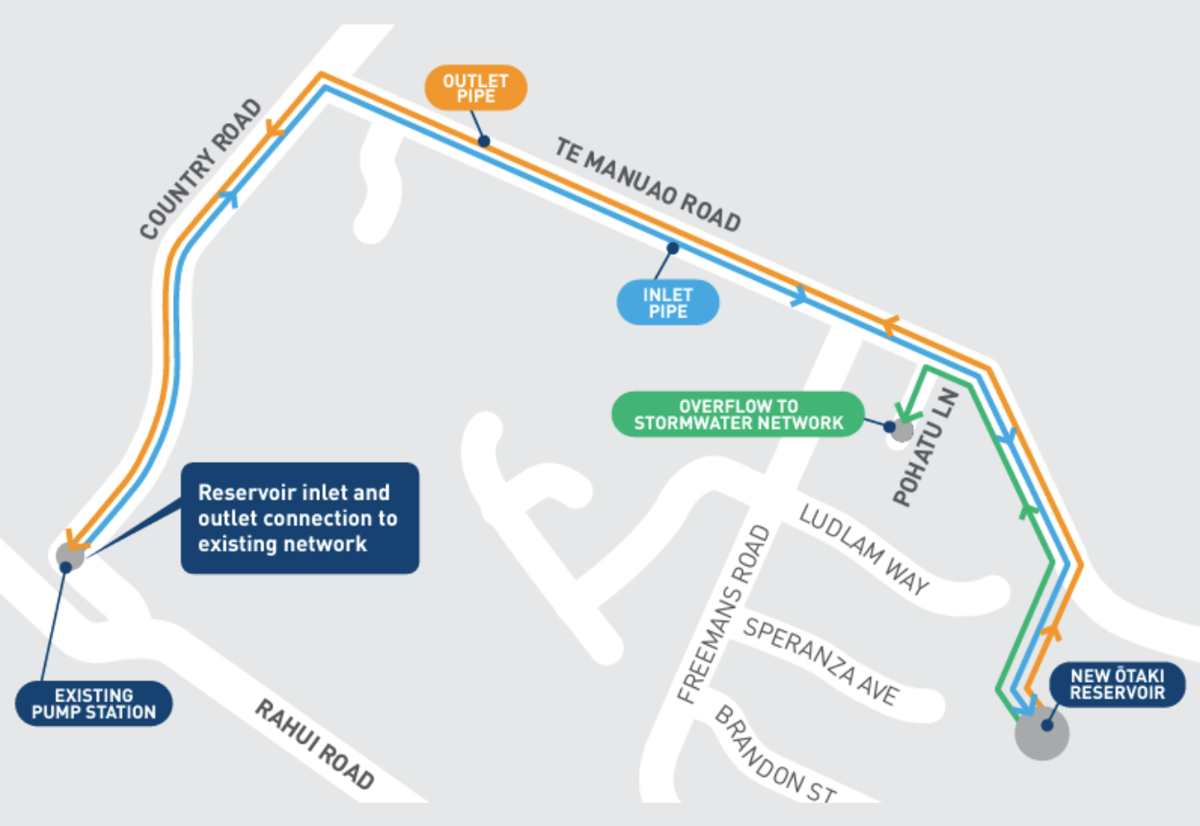

length of pipes to be installed, made up of 1.8km to convey water from the County Road pump station to the reservoir, 1.8km to carry water from the reservoir back to join the reticulation network at the County Road pump station, and 0.5km of pipes for overflow or flushing from the reservoir to join the stormwater network |
$9.1 million |
estimated total cost of reservoir project including associated pipework |
Seismic design
The reservoir is designed to withstand a one-in-2,500-year earthquake, making it one of the strongest structures in the area. During a major earthquake, the tank is designed move a small amount. Movement of around 25mm to 100mm can be expected to occur in a 2,500-year earthquake. Designing for some movement results in better seismic performance compared to a reservoir that is totally locked in place. Pipework will include flexible joints to allow for any movement of the tank.
Latest updates

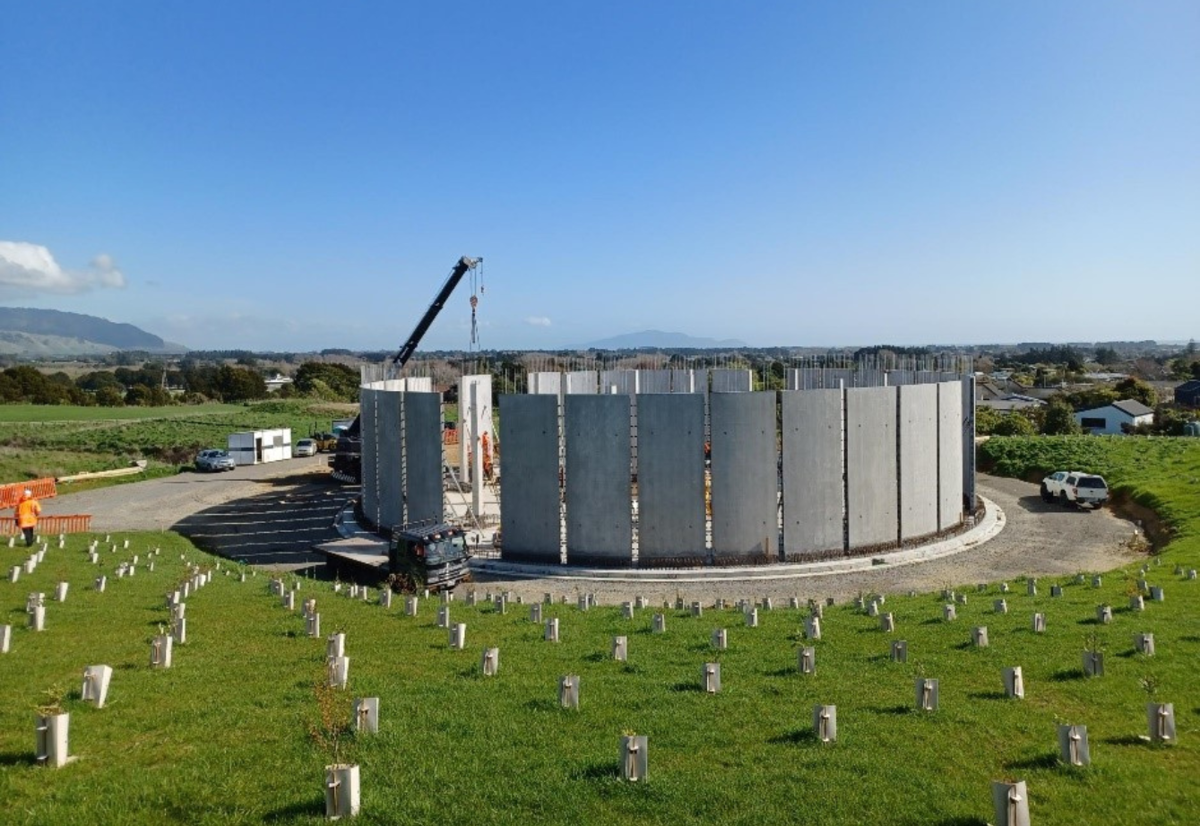

Work on the new reservoir will begin in October. Here’s the high-level timings of construction.
Expected construction timings for the reservoir |
|
Stage |
Estimated Dates |
Earthworks – clearing the area and building earth bunds to help screen reservoir |
October/November 2023 |
Trenching from tank site to Te Manuao Road for pipework |
November |
Ground improvements to provide a strong foundation for the tank |
November/December |
Build concrete pad for reservoir |
January 2024 |
Construct tank and control equipment |
February to June |
Install pipes from site to County Road pump station |
February to June |
Plant native trees to screen the reservoir and create a natural environment |
April/May |
Fill and calibrate tank |
July/August |
Reservoir fully operational |
Late 2024 |
